CONSTRUCTION UPDATES

construction Progress

Web Designer 95%
*According to our internal inspection conducted on 31-07-2025, the overall project's progress is 95%.

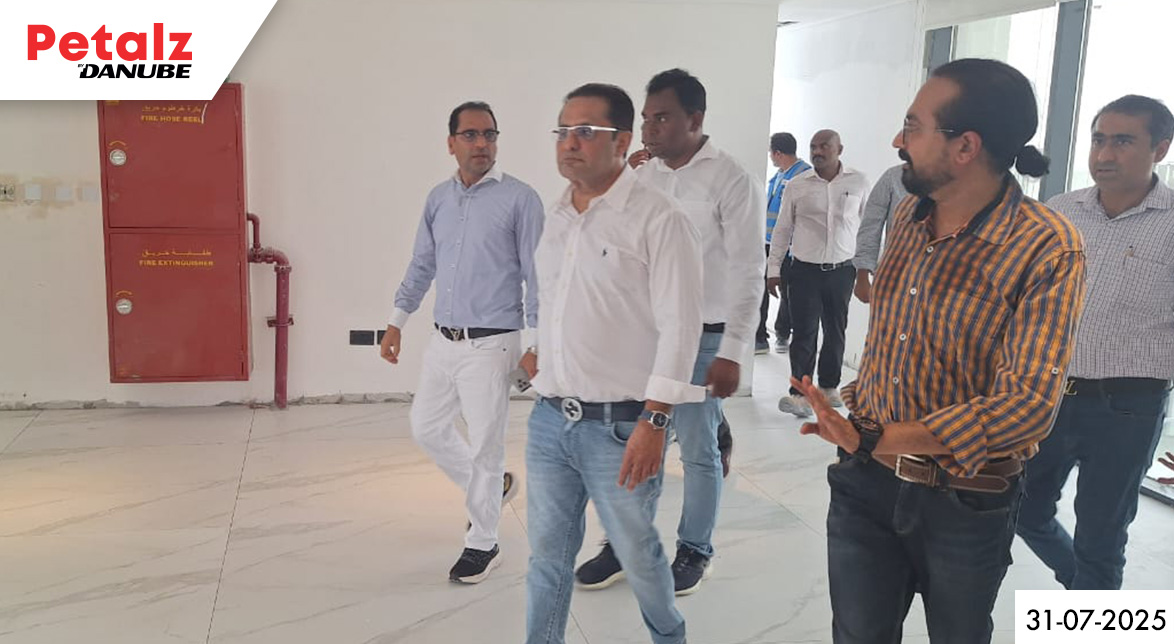

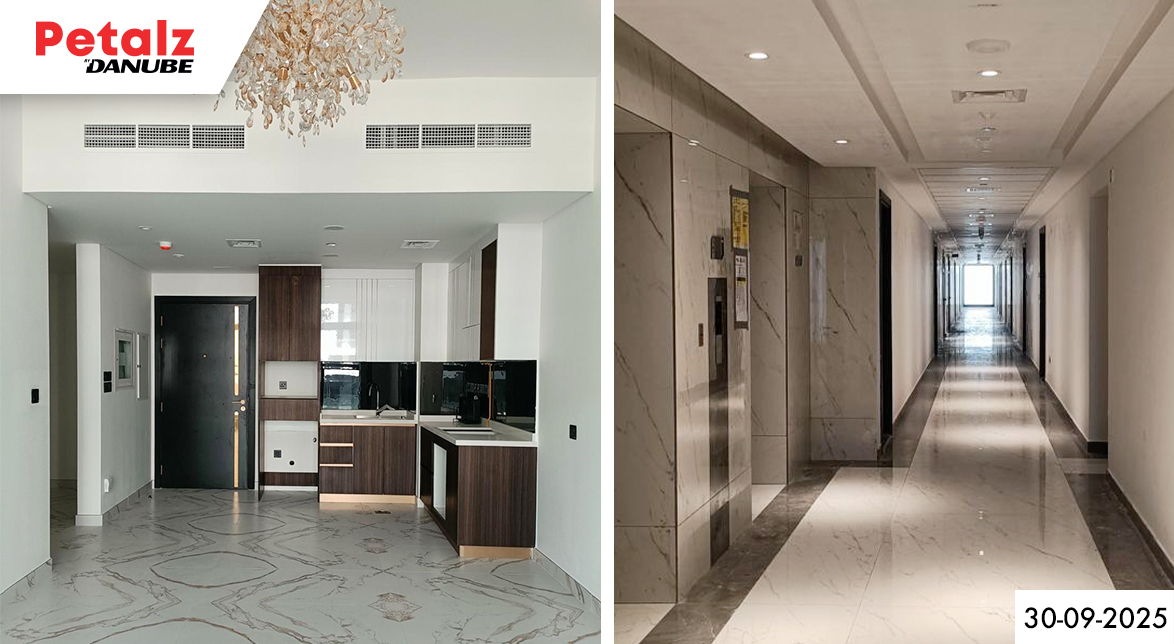

31-07-2025

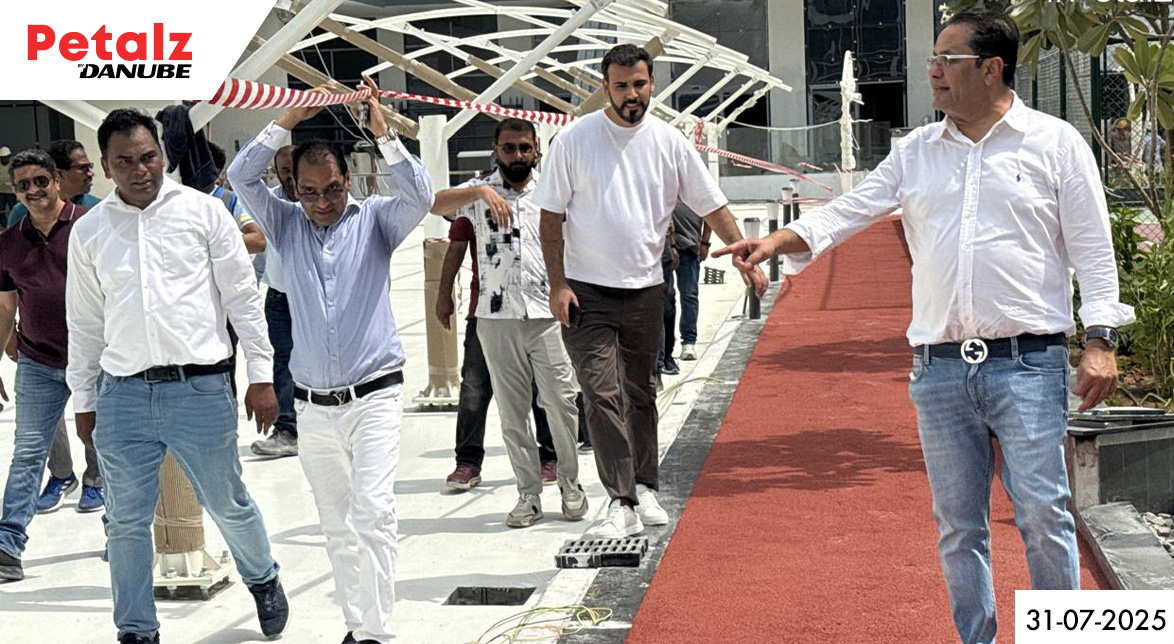

  1. Superstructure completed.

  2. MEP second fix and final fix in progress.

  3. Project is targeted to be completed before time.

  4. All MEP long lead items installed.

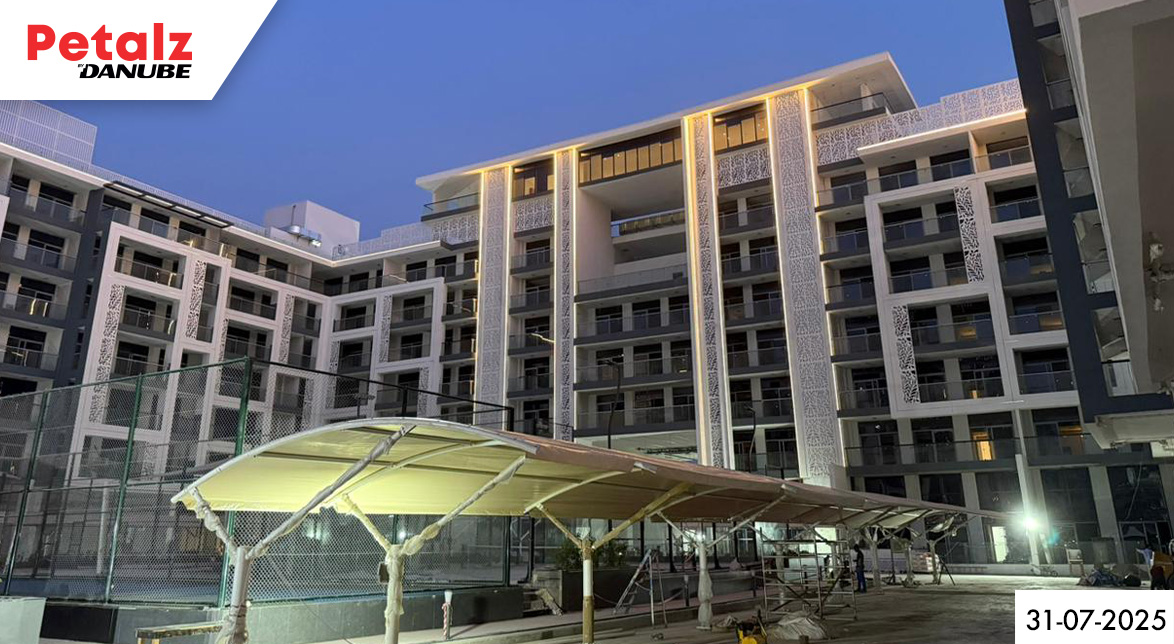

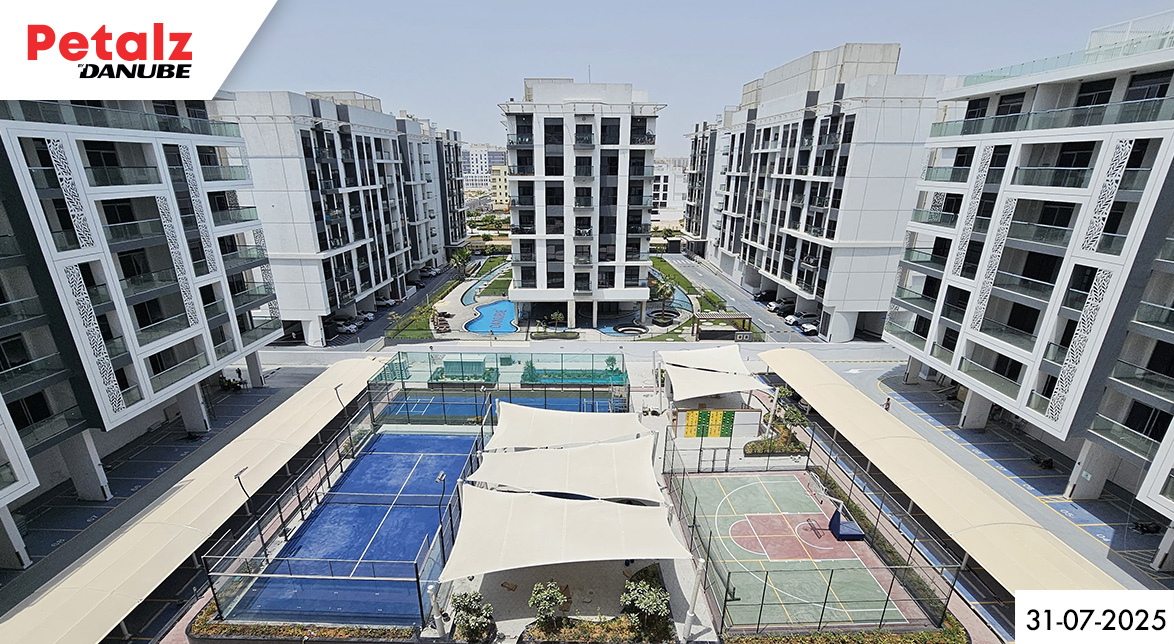

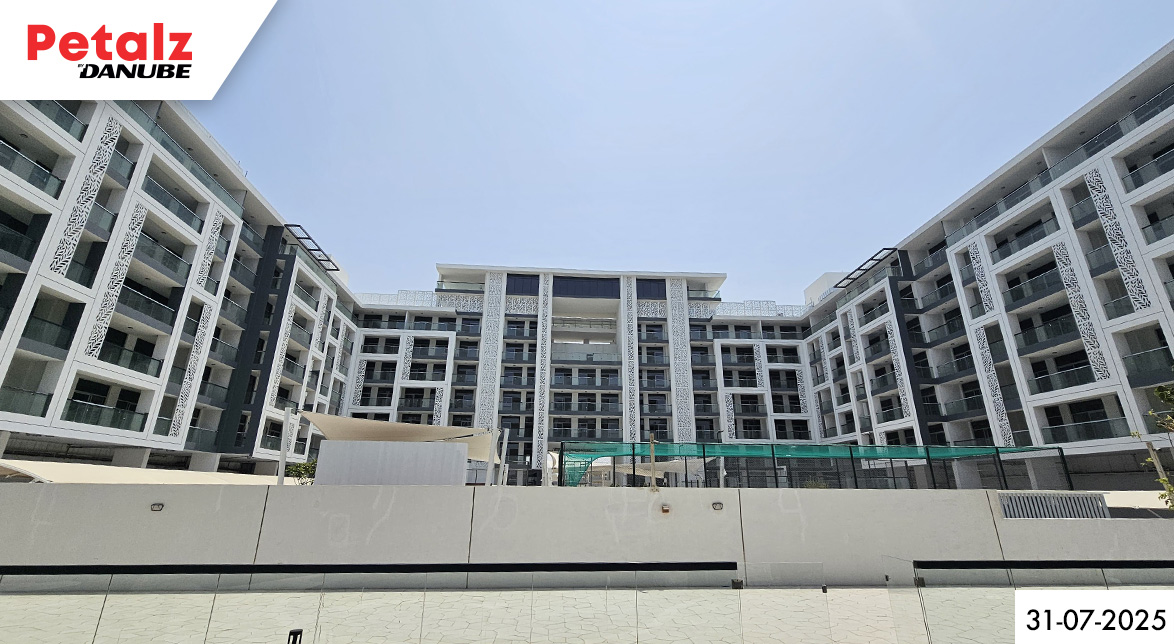

  5. Final finishing works & façade works in progress.

  6. Breaching inlet approved.

  7. LV first inspection by DEWA Completed.

  8. DCD inspection in progress

  9. DEWA power permanent power conection in progress.

    Proudly powered by Wpopal.com

    Get in Touch

    Disclaimer : Danube Properties values your privacy and will use the contact information you provide solely for communicating with you about our products and services. By clicking the submit button, you consent to our sales agents contacting you via phone calls, emails, and WhatsApp messages. You have the right to opt out of these communications at any time. For more details, please review our comprehensive Privacy Policy.

    Real Estate Developer in Dubai
    Follow Us on:
